Acton - Crown Valley Road Phase II

  • Project Scope:
    The primary objective of this project is to resurface 4.7 miles of a major rural road. The project includes the following proposed work: - Pavement resurface
  • Project Benefits:
    This project will reduce road noise for residents and lessen wear and tear on vehicles. This project will also help to preserve natural resources by using recycled and in-place materials, resulting in cost savings and reduction in greenhouse gas, energy, and landfill deposition.
  • Community Engagement:
    A project information flyer and a construction brochure will be provided just after the project has been awarded and a week prior to start of construction, respectively.
  • Project Location:

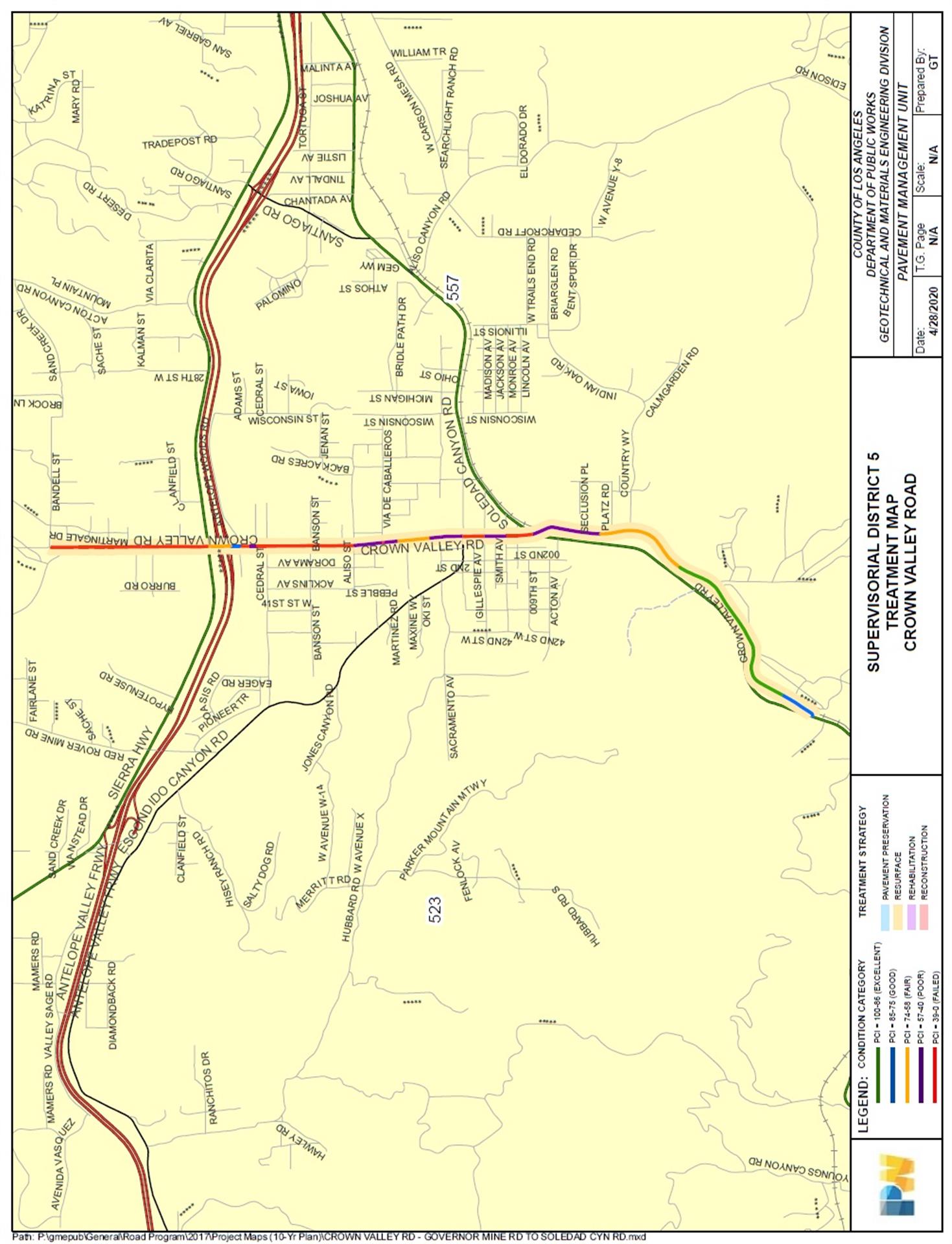

    Unincorporated Community of Acton.
  • Cost Estimate:
    - Total Project: $2,227,000 - Construction: $1,707,000
  • Economic Impact:
    Project construction supports 21 direct and indirect jobs.
  • Schedule:
    - Start of Construction – Jul 2024
    - End of Construction – Aug 2024
