Acton - Sierra Highway from 1200 ft west of Crown Valley Road to 411 ft east of Mountain Springs Road
-
Project Scope:The primary objective of this project is to rehabilitate 4.7 miles of major/local roads.
-
Project Benefits:This project will improve quality of life for residents and lessen wear and tear on vehicles. This project will also help to preserve natural resources by using recycled and in-place materials, resulting in cost savings and reduction in greenhouse gas, energy, and landfill deposition.
-
Community Engagement:A project information flyer and a pre-construction brochure will be provided just after the project has been awarded and a week prior to start of construction, respectively.
-

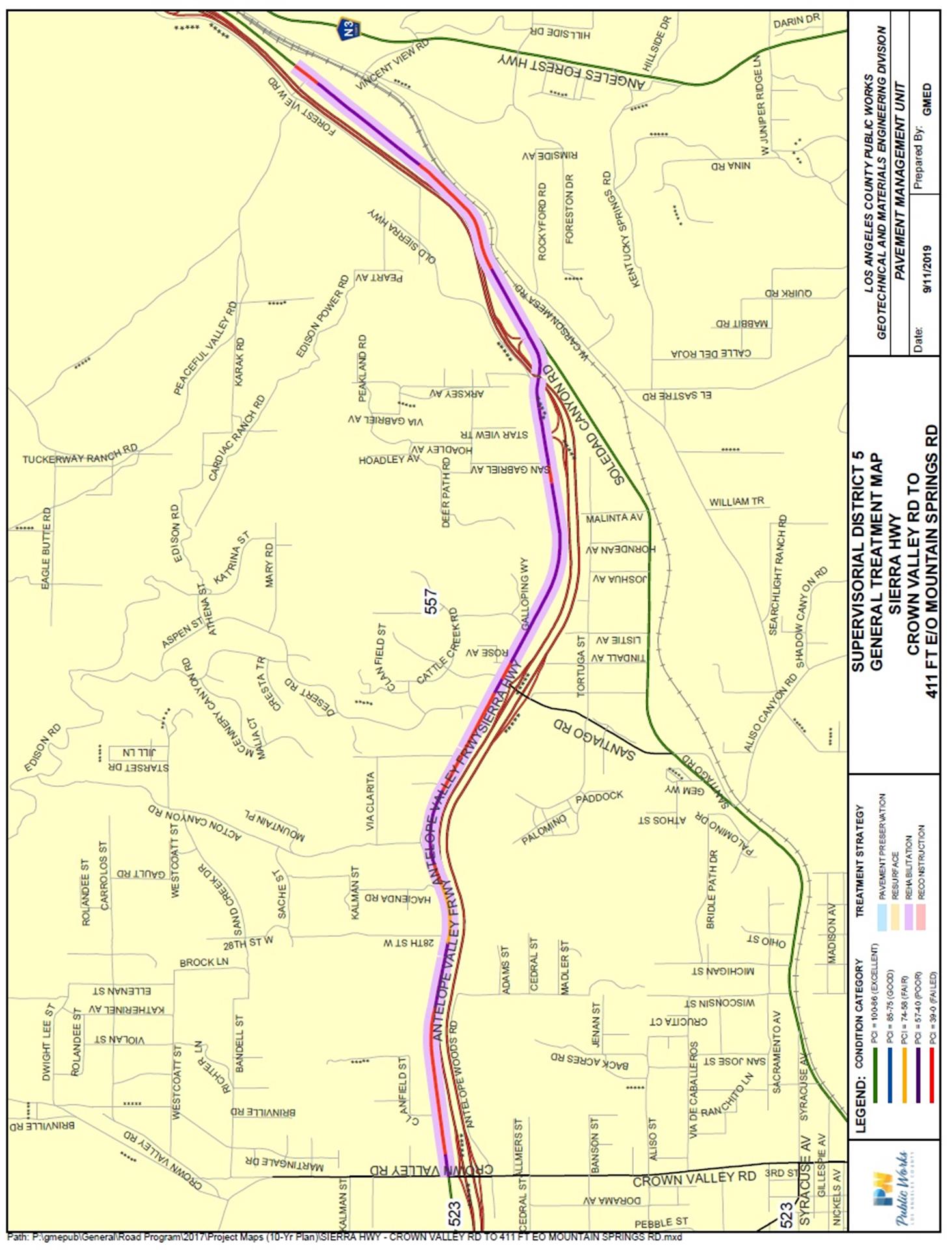

Project Location:Unincorporated Community of Acton.
-
Cost Estimate:- Total Project: $6,000,000 - Construction: $5,025,000
-
Economic Impact:Project construction supports 57 direct and indirect jobs.
-
Schedule:- Start of Construction – Sep 2024
- End of Construction – Dec 2024
